A contractor asking for night work is usually asking for programme recovery. The window that was supposed to be there in week nine is gone, the follow-on trade is already booked, and the only hours left on the calendar are after dark. The machine is the easy part of that conversation. Everything around the machine is what decides whether the night produces anything.
Night work is a scheduling problem, not a machine problem
An excavator does not care what time it is. The people around it do, and so does the site. Before we agree to a night shift we look at three things, and any one of them missing is a reason to say the shift will not deliver what the client thinks it will.

Lighting has to cover the swing, not the cab
Machine work lights are built to light the working face in front of the operator. They are not built to light the full arc that the boom travels through. An operator can dig accurately in the dark. What they cannot do is judge where a bucket of spoil lands once it swings outside the lit zone. The result is a stockpile in the wrong place, which you pay for twice: once to put it there and once to move it in daylight. Tower lights positioned to cover the swing radius and the loading point are cheap next to a day of re-handling.
The crew has to be rostered for nights
Day crew stretched into a second shift lose accuracy well before they lose speed. On a site with live services, finished surfaces or a tight boundary, accuracy is the thing protecting everything underneath. Because our operators are our own, a night shift is a roster change on our side rather than a negotiation with a sub-supplier who already has another client booked in the morning. That is the practical difference between a supplier saying yes and a supplier actually turning up at 8pm with someone who has slept.
Haulage has to keep pace with the bucket
This is the one most often left out of the request. A machine digging at night with nothing to load into is an expensive floodlight. Spoil that cannot leave site fills the working area, and by sunrise the day crew inherits a platform they cannot work on. When we quote a night shift we quote the lorry tipper alongside the machine so the material moves as it comes out.
What to tell your supplier when you ask for nights
Four lines is enough for a number: what the work is, where the site is, which nights you need, and whether there is a noise or access restriction on the estate. Many Johor industrial estates and data centre sites have their own night access rules, and those rules change what we send more than the volume does.
Where the long arm fits

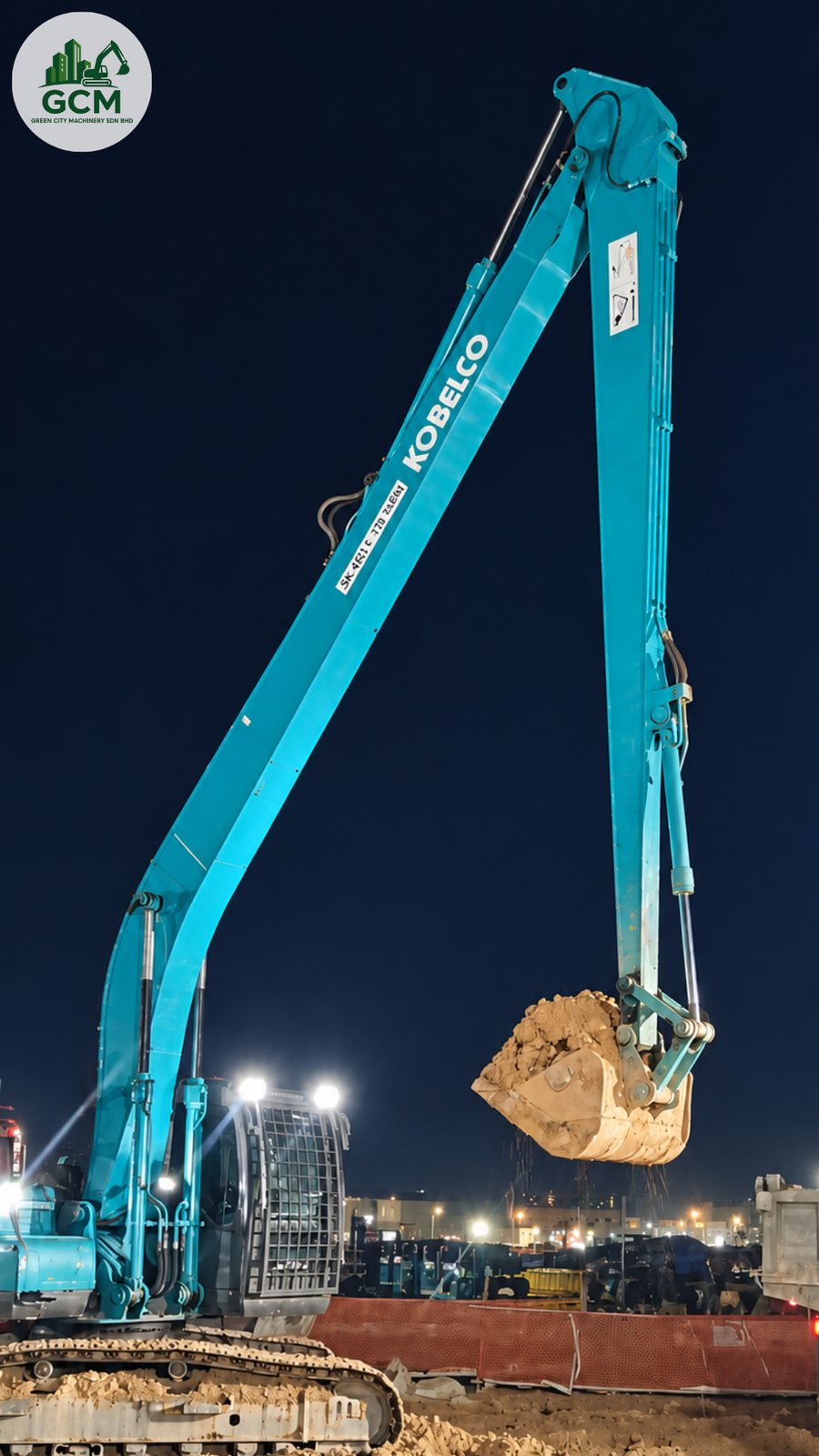

The long arm excavator comes into night work more often than people expect, because the jobs that get pushed into a night window are frequently the ones with depth or reach constraints. Where a standard boom would need benching or a second position, the long arm reaches from a single set-up, which matters when you are paying for lighting by the hour and have one shift to finish. If the constraint is volume rather than depth, a standard 20-tonne excavator is the machine for the same window.
If your programme has slipped and nights are the only window left, tell us the date you are chasing. We will tell you what it takes to hold it, and be straight with you if it cannot be held. Contact us at +6011-105 95686.
